Delivering 132kV Terminal Structure & EHV Earthing Works for Winkburn Solar Farm

Challenge

  • Working adjacent to live 132kV overhead lines.
  • Managing and maintaining strict adherence to environmental controls with the ancient woodland bordering the site.
  • Delivering works within a reduced working footprint.
  • All works had to be delivered using made-to-order components.

Solution

To mitigate ground and environmental risks, we installed trackway to protect the land and maintain safe access. Our specialist EHV team then:

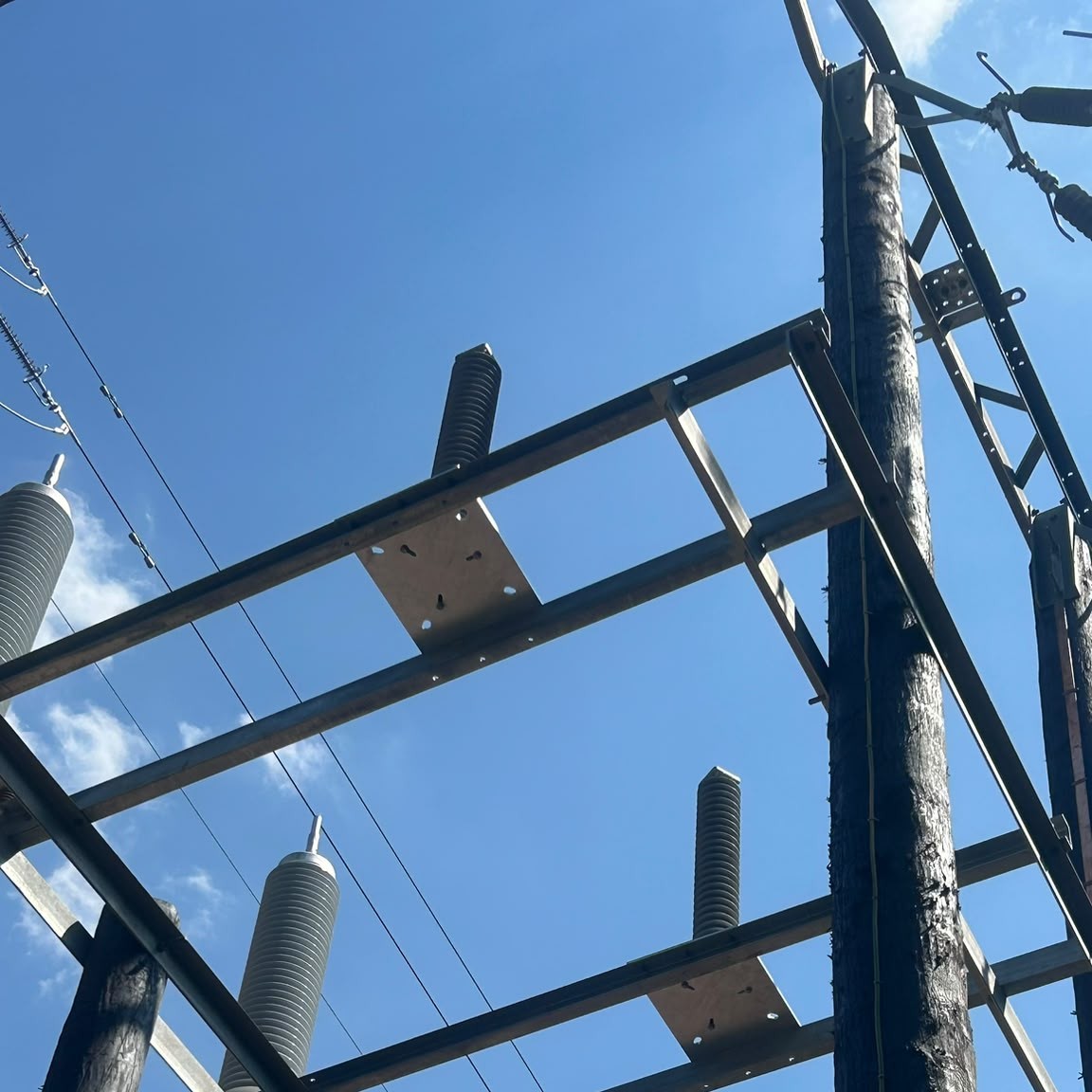

  • Assembled and dressed the four-pole terminal structure with cable sealing ends and surge arrestors.
  • Installed foundations and GS6 compliance measures
  • Delivered earthing works including 2no. bonding connections to the new substation
  • Coordinated daily with multiple contractors and NGED
  • Applied strict environmental controls due to proximity to ancient woodland
  • Ensured all activities complied fully with the approved RAMS

Outcome

  • Completed four-pole terminal structure and earthing installation on time and within budget
  • Fully compliant with NGED adoption standards
  • Safe delivery despite wet conditions and environmental sensitivities
  • All works completed and ready for NGED to undertake the non‑contestable tower connection
Delivering 132kV Terminal Structure & EHV Earthing Works for Winkburn Solar Farm

Project Location

Winkburn Solar Farm, Nottinghamshire

Client

Sonnedix

Description

IES Utilities Solutions was engaged by Sonnedix to deliver the EHV 132kV four pole terminal structure and associated earthing for the Winkburn Solar Farm in Newark, Nottinghamshire. Although an outline design already existed, our team undertook a full design review and necessary amendments as part of taking on the works. The project scope included engineering, project management, a full technical design review, site supervision, structure construction, and installation of 2no. bonding connections to the new 132kV substation.

Key Stats

  • Technical Design Review and build of 132kV four-pole terminal structure
  • 2no. bonding connections to new substation
  • Clear interfaces with NGED for contestable / non contestable boundaries
  • Mobilised within 4 weeks

Project Delivered

July 2026
